WinCC Unified

From Comfort Panel to WinCC Unified, with a better panel than before.

Siemens is phasing Comfort Panels out of its catalogue and points to Unified Comfort as the successor. We port existing HMI projects to WinCC Unified — conversion, rebuilding what conversion doesn't cover, validation with the operator — with the method tested at the Siemens hackathon.

The comparison shown at the hackathon: the WinCC Unified panel on the left, the Comfort panel in use on the right. Silent video, sped up to 1.25x; end-customer references are blurred.
Why now

The Comfort line is closing

Since 1 October 2024 the 15, 19, and 22-inch Comfort Panels have been in product cancellation: they're only available as spares. The successor Siemens points to is the Unified Comfort series.

TP1500 · KP1500 · TP1900 · TP2200 → Unified Comfort

Unified isn't a version upgrade

The runtime is built on web technologies, scripts are written in JavaScript instead of VBScript, and the panel also opens in a browser. A Comfort project doesn't recompile: it gets converted, and what conversion doesn't cover gets rebuilt.

WinCC Comfort/Advanced → WinCC Unified · TIA Portal

Choose when, not whether

Migrating pays off at a moment you choose — a machine overhaul, a new order, a planned shutdown — not at the first failed panel with no spare on the shelf.

Planned shutdown · new order · overhaul

The method
  1. Analysis of the existing project

    We study the Comfort or Advanced project: what to keep as it is, what's worth changing, which objects conversion won't carry over.

  2. Basic navigation and functions

    We rebuild the screen structure and the core functions, so the panel is operational from the first tests.

  3. Automated conversion

    Objects and tags move in bulk from the original format to Unified using conversion tools: ready screens and tags already connected.

  4. Operator experience

    Layout and visual consistency redesigned for the people who use the panel every day, with security designed in from the start, not added later.

  5. Customization

    Project-specific objects, Custom Web Controls, and the extensions automated conversion doesn't cover.

  6. Testing and validation

    Functional verification against the original system and validation with the operator, before go-live.

What changes for the operator
Before · WinCC Comfort
The machine's Comfort operator panel: status tables, hash-mark counters, and a side menu of buttons
After · WinCC Unified

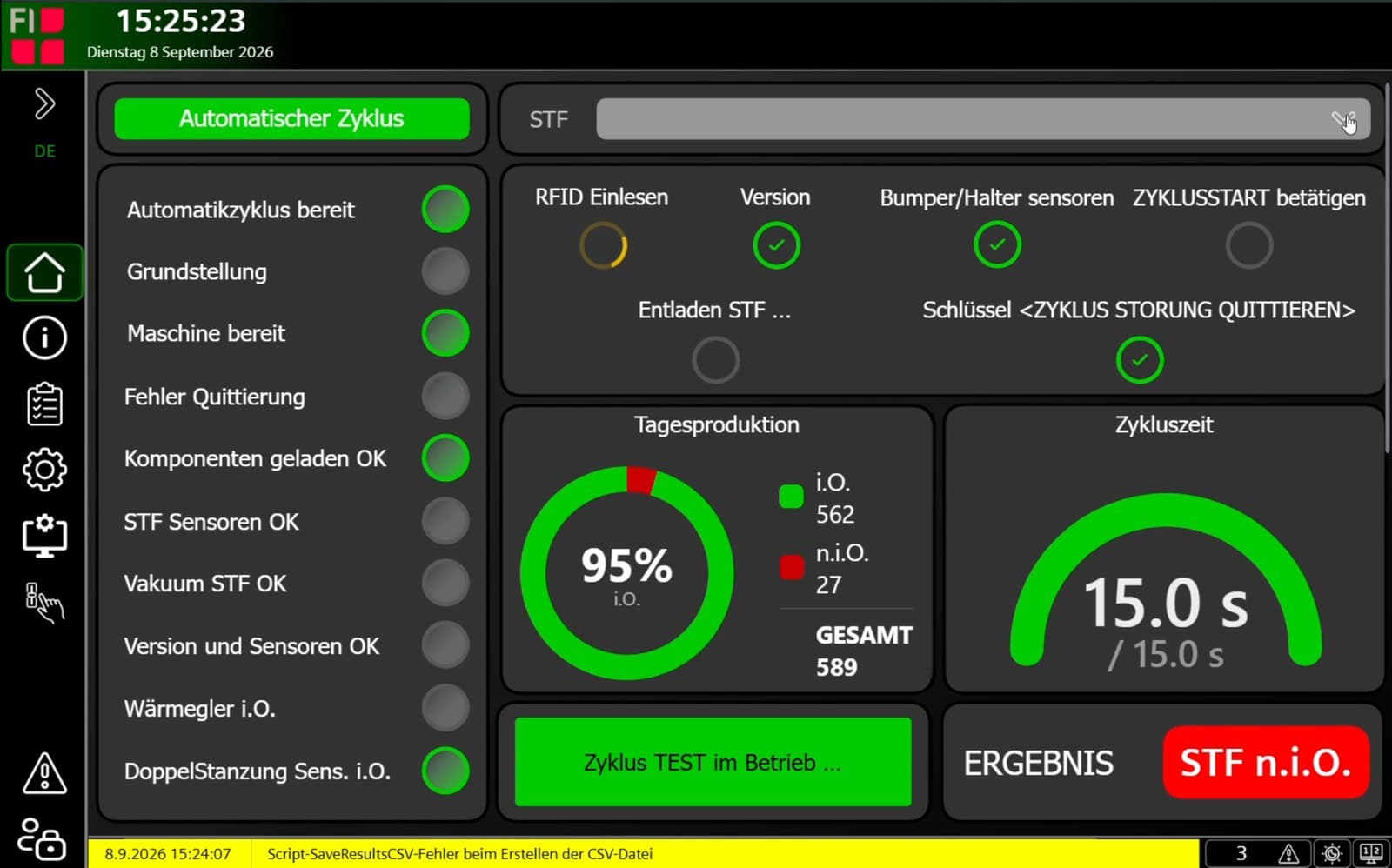

The same panel on WinCC Unified: states as circular indicators, daily production on a donut chart, and cycle time on a gauge
The same machine's main screen, before and after migration. End-customer references are blurred on the Comfort panel.

Flat navigation

A few horizontal tabs and no nested menus: the operator reaches any screen in two taps.

horizontal tabs · side menu collapsible to icons

Production at a glance

With Custom Web Controls production reads as charts and indicators — shift by shift, part by part — instead of tables of numbers.

Custom Web Controls · charts · circular indicators

The machine in 3D

Instead of two-dimensional icons, an explorable 3D model of the machine, station by station: useful to the operator and above all to maintenance.

Custom Web Control · interactive 3D model

Faceplate diagnostics

Safety, Profinet diagnostics, and alarms shown through standard faceplates: easier to read than the old panel's dense tables, with the same detail.

faceplates · S7 safety · PN diagnostics · alarm indicator

Two screens at once

Split screen shows two independently navigable contexts: what commissioning and maintenance need.

split screen

The panel in a browser too

With the Web Client the same interface opens on several monitors or a dedicated workstation, without a second project.

Web Client · multi-monitor · dedicated workstation

What to plan for

Reports and printouts

Report configuration goes through an add-on and is more involved than on Comfort; the output doesn't replicate the screen and decimal precision needs checking. If reports are part of customer acceptance, they're redesigned and validated separately.

Per-screen limits

The number of Custom Web Controls and faceplates on a screen is limited: page structure is designed around that, not discovered at testing.

Scripts without a debugger

A project can compile without errors while a script doesn't work. Scripts are tested one by one on the panel, and that testing belongs in the schedule.

Hardware load

More web components per page lengthen loading times: the successor panel is chosen for the project, not from the catalogue.

Events on page load

A field's change event also fires when the page loads, with the value unchanged: logic that relies on it has to be written to not treat it as a new value.

Siemens hackathon

At the WinCC Unified Hackathon 2026 organized by Siemens, IOMA worked as system integrator in a team with F.I. Automazione, a builder of welding machines for plastic components based in Caramagna Piemonte, Italy. The project, called Kolibrì, was migrating the operator panel of one of their machines from Comfort to Unified.

The panel was loaded onto a test machine and put in front of operators next to the one in use: same machine, same data, two different experiences. The six-step method and the rules to plan for on this page come from there.

Event
WinCC Unified Hackathon 2026 · Siemens
Team
IOMA, system integrator · F.I. Automazione, machine builder
Migration
WinCC Comfort/Advanced → WinCC Unified
Project
Kolibrì

PLC programming and integration

Go to the PLC service

Machine logic, structured alarms, and data exposed to panel, SCADA, and MES on Siemens PLCs.

Industrial HMI and shop-floor UX

See industrial HMI

Operator interfaces consistent across the stations of a line, designed for the people who use them every shift.

Teleservice

See teleservice

Secure remote support on PLC, SCADA, and HMI, including after the new panel goes live.

Frequently asked questions

Do installed Comfort Panels stop working?

No. A panel already on the machine keeps working as before: what changes is availability. Since 1 October 2024 the 15 to 22-inch models are only available as spares, and the direction Siemens points to for the whole line is Unified Comfort. The real risk isn't the panel that works today, but the one that fails in a few years with no spare on the shelf.

Does a Comfort project convert to WinCC Unified automatically?

Partly. Objects and tags convert in bulk with the conversion tools, and that's the step that saves the most time. What's left out are scripts — on Unified they're written in JavaScript, not VBScript — project-specific objects, reports, and whatever is worth redesigning for the operator. In IOMA's method automated conversion is step three of six, not the whole job.

Does the PLC need to change too?

Usually not: the panel changes, the machine logic stays. During analysis, though, communication with the installed controller has to be checked, especially on older PLCs, and it's the right time to clean up tags and alarms the panel currently rebuilds on its own. That's why IOMA does the migration with people who also know the PLC program.

Is a new TIA Portal version needed?

Yes: WinCC Unified is engineered in TIA Portal with its own engineering licence, and the version determines which functions are available on the panel. It's one of the first things IOMA checks during analysis, together with runtime licences and the successor panel model.

Should we copy the panel as it was or redo it from scratch?

Neither, entirely. Copying one-to-one wastes the only occasion when the interface gets rebuilt anyway; overturning it costs operators days of training. In the hackathon project IOMA kept the information and flows the operator knows and changed how they're reached: flat two-tap navigation, charts instead of tables, faceplates for diagnostics.

How long does a Comfort to Unified migration take?

It depends on the number of screens, the scripts, and how many objects conversion doesn't cover: that's why the first step is analysing the existing project, which gives an estimate based on numbers rather than gut feeling. What can always be fixed is the shutdown window: the new project arrives on the machine already tested, and only acceptance with the operator is left on the floor.
